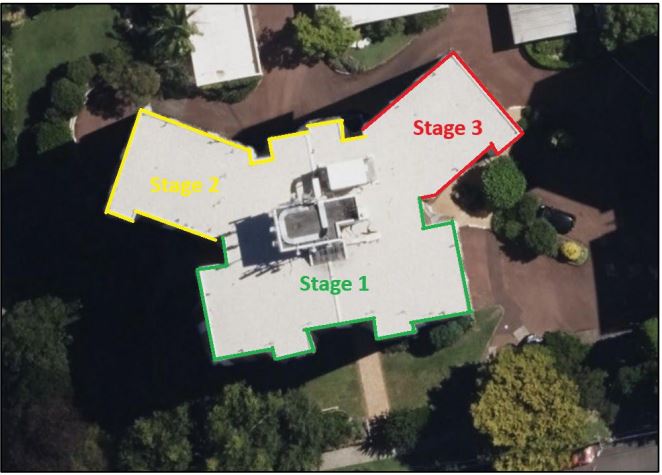

Stage One Starts

A hard copy of this document was distributed to all owners on the 25th of June by Preservation Technologies. It contains information about access, restrictions and hints for dust control. Read More

Owners can go to the owners portal to access information in preparation for the AGM or email office@stratapartners.com.au if you haven’t received your link to the online meeting.

Stage 2 estimated to commence early November with all D and E apartments.



On Wednesday, 25 June 2025 the gardener will be removing the existing garden plants and vegetation from the Shirley Road frontage in preparation for the installation of the scaffold for Stage 1.

The vegetation may be stacked on the south-west corner for a short period until it can be removed.

We are in discussions with the gardener to replace the plantings at the end of each stage as soon as the scaffolding comes down and we’d love input from residents as to the new plantings.

Around 20 people attended the Meet the Builder information evening on Thursday. The mood was positive and there were a lot of good questions asked. Funny to think we’d be excited about embarking on 10.5 months of scaffolding, dust and noise but there’s been a lot of hard work put in to get here and the results will be worth it. Most importantly these are important remedial works that will ensure ‘Shannon’ is preserved and protected for another 50 years.

NOTE: If you haven’t done so already text site supervisor, Cory with your name and unit number so he can easily reach you throughout the project. Cory’s number is: 0424 189 225

Some key take aways from the evening;

  • Work starts 30th of June with the erection of swing stages and scaffolding to Stage 1 (A & B units)
  • Stage 1 residents will be contacted by Pres Tech to arrange access to their units for a check measure so that your new windows and doors can be put into production mid July with installation estimated to commence in August.
  • Stage 1 scaffolding will be in place until the end of November subject to the weather. Stage 1 swinging stages will be removed earlier and moved to the next stage.
  • Working hours are 7.00am – 5.00pm Monday – Friday. Noisy Works are permitted from 7.30am – 5.00pm Monday to Friday
Your Responsibilities
  • Once window installation commences on your stage be ready to remove your window coverings a few days before they reach your apartment until installation is complete. Residents are also asked to shift furniture away from the windows, a 1 metre setback is ideal. Window coverings can be replaced after the window and doors are installed but may need to be removed again for the making good activity. NOTE: windows will be installed in stages, approx 2 to 3 windows in a day.
  • Residents are also responsible for the removal of all items on balconies such as pot plants, furniture and the like prior to the construction of the scaffold being erected on their side of the building / construction stage.
Important Considerations
  • Once construction and scaffolding has commenced balcony access will not be available for safety reasons and the doors will be locked from the outside.
  • When installation is not underway on your windows and doors you may wish to keep your curtains drawn and blinds down for privacy. Window should be kept closed as much as possible to stop dust and reduce noise.

There’s more useful information on the FAQ page. read more





The contract with Preservation Technologies has now been uploaded to the owners portal. Owners can access the portal from the top right navigation button on this website using their own unique log in.

The contract includes drawings and plans for the work to be completed.



Stage 1 is estimated to commence on the 7th of July through to November 2025. If you are in this stage instructions will be available soon. Stage One includes all A & B apartments.
